Aerial construction field study

Helicopter Concrete Pouring & Bucketing

Helicopter concrete pouring carries concrete in a bucket to forms beyond pump and truck reach. The placement rate depends on the aircraft's allowable load on the day, the shuttle distance and the work at both ends of each flight, so it comes from the operator's plan for the actual site. Batch timing, bucket size and pour cadence are set before the first pick. When a pump can reach the forms, the pump is the baseline to beat. This page explains what drives both decisions.

Read the Part 133 Reference
90 min ASTM C94 discharge limit after batching, the clock the flight cycle is planned against
Per site Placement rate, from the operator's cycle plan for the actual forms and conditions
Class B The 14 CFR 1.1 load class for a jettisonable bucket lifted free of the surface

Once the batch plant loads the truck, the concrete's workability and discharge limit start running down, and a late load risks a cold joint. That holds whether the pour is a tower foundation at 9,500 feet or a bridge pier at the bottom of a roadless canyon. Aerial concrete placement is used for pours like these: mountain footings, transmission tower foundations, dam and spillway repairs, and remote piers where the alternative is building a road for the job.

Maximum lift capacity is not the figure that decides an aerial pour. The cycle rate matters more: how many pick-to-pour rotations the aircraft completes per hour, how many yards each bucket carries under the day's conditions, and whether that cadence stays ahead of the concrete's initial set. The operator works through all three before an aircraft is committed. If the aircraft places concrete more slowly than the previous layer sets, the pour will have cold joints.

This page explains the planning inputs for estimators and engineers. For the broader crane-versus-rotorcraft comparison on commercial sites, start at the aerial construction hub. For the rules behind every external load flight, see external load operations.

ASTM C94 90-minute discharge limit OSHA 1926.551 Ground crew rule

The mission set

Where Helicopter Concrete Pouring Wins

Each ground delivery method has a reach limit. A truck chute needs the mixer within a few feet of the forms. A boom pump needs a set-up pad, and its reach is limited by the boom. A line pump extends further but needs continuous pipe runs, access for the pump truck, and pressure that holds up over the vertical rise and distance.

When the pour sits beyond all three, the usual alternative has been a temporary road. Clearing, grading, erosion control, environmental review and reclamation all go into that road's cost, even when it serves one pour sequence. Put those costs beside the aerial estimate.

The helicopter is usually worth comparing on these jobs:

  • Transmission and telecom tower foundations. Drilled pier and spread footing pours along ridge lines, sequenced with tower construction flights so foundations and steel can share a mobilization.
  • Dam, spillway, and penstock work. Placement onto faces and benches where crane geometry does not work and anchoring a pump line is impractical.
  • Remote bridge piers and abutments. Stream crossings where in-water access is restricted and a temporary causeway needs its own permits.
  • Mountain footings for tramways, lifts, and instrumentation sites. High-elevation pours where density altitude, rather than access, limits the load. The mining operation support page discusses high-altitude payload planning.
  • Backcountry structures and trail infrastructure. Small-yardage pours for agencies and contractors working under land-use rules that prohibit new road cuts.

The planning numbers

How Many Yards of Concrete Can a Helicopter Place per Hour?

Fresh normal-weight concrete weighs about 150 pounds per cubic foot, close to 4,000 pounds per cubic yard before the bucket's own weight is added. That figure drives aircraft selection. The yards per bucket follow from the aircraft's allowable load for the site and day, less the bucket and rigging. Multiply that by the cycles the operator expects per hour to get the placement rate.

No fleet-wide rate holds for every pour. Shuttle distance, the time at the hopper and the forms, and the conditions on the day all change it. The published capacities below are maximum figures from each source, with different bases. They show the scale of each aircraft, not what it can carry at a particular site. Capacity depends on the specific aircraft and lift-day conditions, and the lift plan should account for that before pour day.

Utility helicopter carrying a concrete hopper on a longline against open sky
The bucket cycles between the staging hopper and the forms; the placement rate lives or dies on how many of these rotations the aircraft completes per hour.
Aircraft Max external load Approx. concrete per cycle Cycles per hour Effective placement rate
Bell 212 Eagle SingleNot published hereNot published hereNot published hereNot published here
Bell 412EP4,500 lb (Avincis specifications, page 4: maximum hook load)Not published hereNot published hereNot published here
Kaman K-MAX K-12006,000 lb (Kaman: published lifting capacity)Not published hereNot published hereNot published here
Bell 214B Big LifterAbout 8,000 lb (McDermott Aviation: 3,636 kg maximum hook load)Not published hereNot published hereNot published here
Sikorsky S-61N Mk II10,000 lb (Helimax: external capacity at standard day, sea level)Not published hereNot published hereNot published here
Erickson S-64E Air Crane20,000 lb (Erickson: maximum external cargo)Not published hereNot published hereNot published here
Erickson S-64F Air Crane25,000 lb (Erickson: maximum external cargo)Not published hereNot published hereNot published here

Concrete per cycle, cycles per hour and placement rate are not published here because each depends on the bucket, the rigging, the shuttle distance and the lift-day conditions. The operator's estimate for the actual pour should state them, along with the assumptions behind them. A published capacity is a maximum from its source, not an allowance for a particular site.

Two aircraft in the table need further comment. The K-MAX has intermeshing rotors and is built for repetitive external-load work. The S-64 Air Crane family carries the largest published loads in the table, and its aft-facing pilot station gives the pilot a view of the bucket during placement. On a large foundation, a bigger bucket means fewer cycles, but ferry distance and standby still belong in the S-64's estimate.

Kaman K-MAX helicopter working a longline over forested terrain
The K-MAX's intermeshing-rotor design supports a 20 to 25 pick-per-hour cadence, the highest cycle rate in the working fleet.

The schedule discipline

How Is a Continuous Pour Maintained with Flight Cycles?

Cold joints are planned out of an aerial pour. A cold joint forms when fresh concrete is placed against concrete that has reached initial set. On a remote pour, the variables that cause one are mostly scheduling variables: truck arrivals, cycle time and the size of each lift area.

Batch timing is flight timing. ASTM C94 requires ready-mix discharge within 90 minutes of batching. On an aerial pour the planning team works backward from that limit, sequencing truck arrivals at the staging LZ against the aircraft's cycle time so no load waits at the hopper losing workability. The batch plant dispatcher and the operator's flight coordinator work from the same schedule.

Cycle cadence is matched to set time. The mix designer supplies the initial set window for the specified mix at the forecast site temperature. The lift plan checks that the aircraft's cycle rate covers each lift area before the previous layer sets, with margin. If cycle distance or yardage erodes that margin, resolve it before mobilization: a hydration-stabilizing or retarding admixture in the mix design, a second aircraft on the rotation, or a revised pour sequence broken at planned construction joints.

Slump is managed at the hopper. Aerial buckets discharge through a gate the pilot or a ground crew member opens over the form. Concrete with slump outside the design range can hang up in the bucket or segregate on discharge. Ground crews check slump at the staging area against the pour plan and reject loads outside tolerance, as a finisher would at a chute.

Weather holds are pre-planned. The pour plan defines the wind and visibility limits that pause flying, along with what happens to concrete in transit and at the plant when a hold is called. That decision belongs in the plan before flying starts, not in the air with a loaded bucket on the hook.

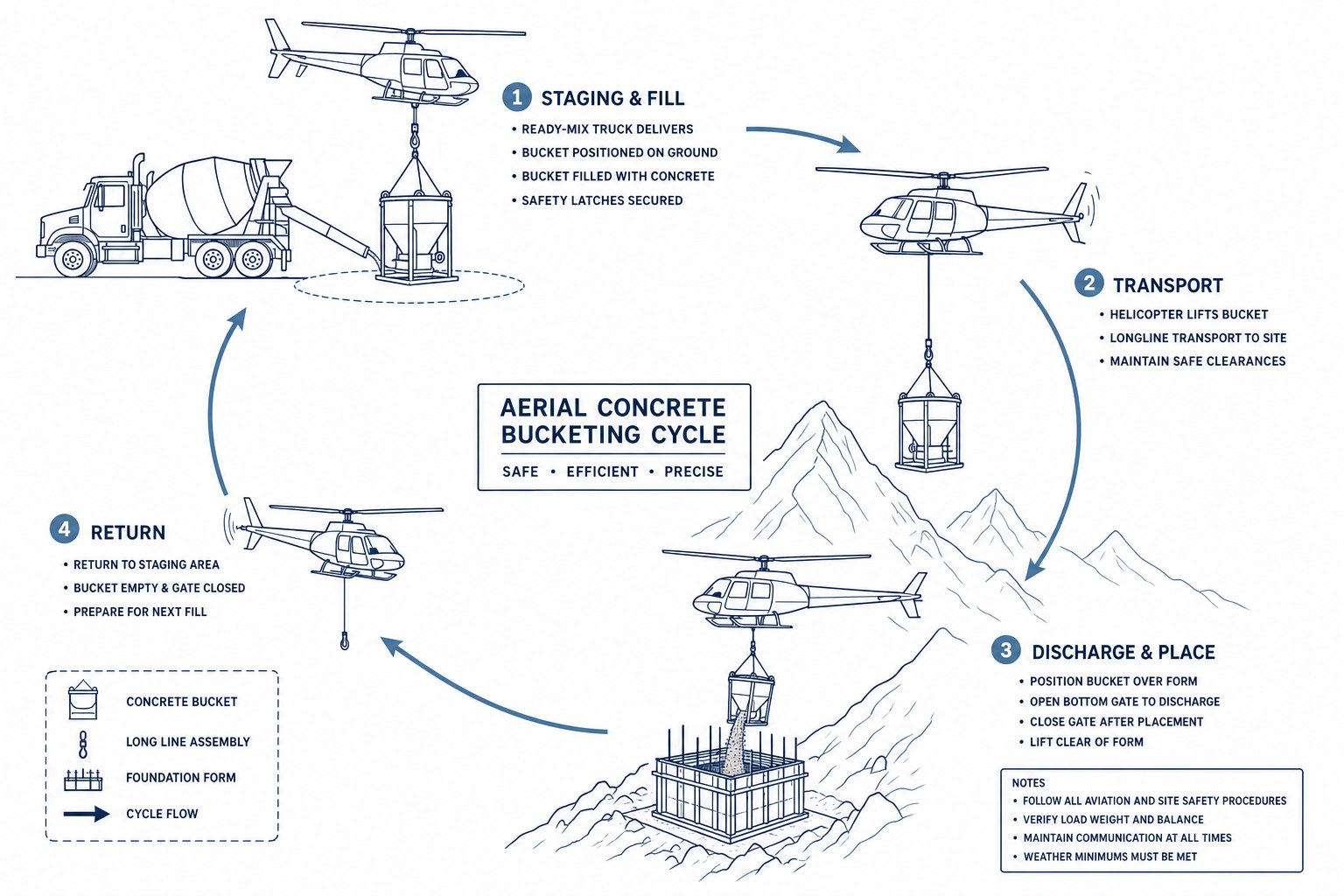

Diagram of the aerial concrete bucketing cycle: bucket filled from a ready-mix truck at the staging area, longline flight to a mountain foundation form, gated discharge, and the return leg to the next fill
The pick-to-pour loop. Every leg is scheduled against the ASTM C94 90-minute discharge clock before mobilization, so no load waits at the hopper.

The physics tax

What Happens to Helicopter Concrete Bucket Capacity at Altitude and in Heat?

Allowable load changes with the conditions. Density altitude describes air density as an altitude: higher elevation, higher temperature and higher humidity all raise it, and thinner air reduces the aircraft's performance. Mountain pours often combine all three. The FAA Helicopter Flying Handbook, chapter 7 explains how these conditions affect performance. No single percentage applies to every aircraft; the operator uses the specific aircraft's performance data for the expected conditions.

Consider a K-MAX, with Kaman's published 6,000 pound lifting capacity, working a tower foundation site at 6,500 feet elevation on an 85 degree July morning. The density altitude there is well above the field elevation, and the allowable load is lower than the published figure. A bucket sized for sea level may be too heavy once loaded. The usual responses are a smaller bucket or a reduced fill line, a recalculated cycle count, and a pour schedule built around cooler morning hours, when density altitude is lower. The operator should run this check before the job is priced and show it in the lift plan as capacity for the expected conditions, then check it again on pour day.

Airframe selection follows from that check. For the highest pours, compare the candidate aircraft's performance data at the expected density altitude rather than its sea-level capacity.

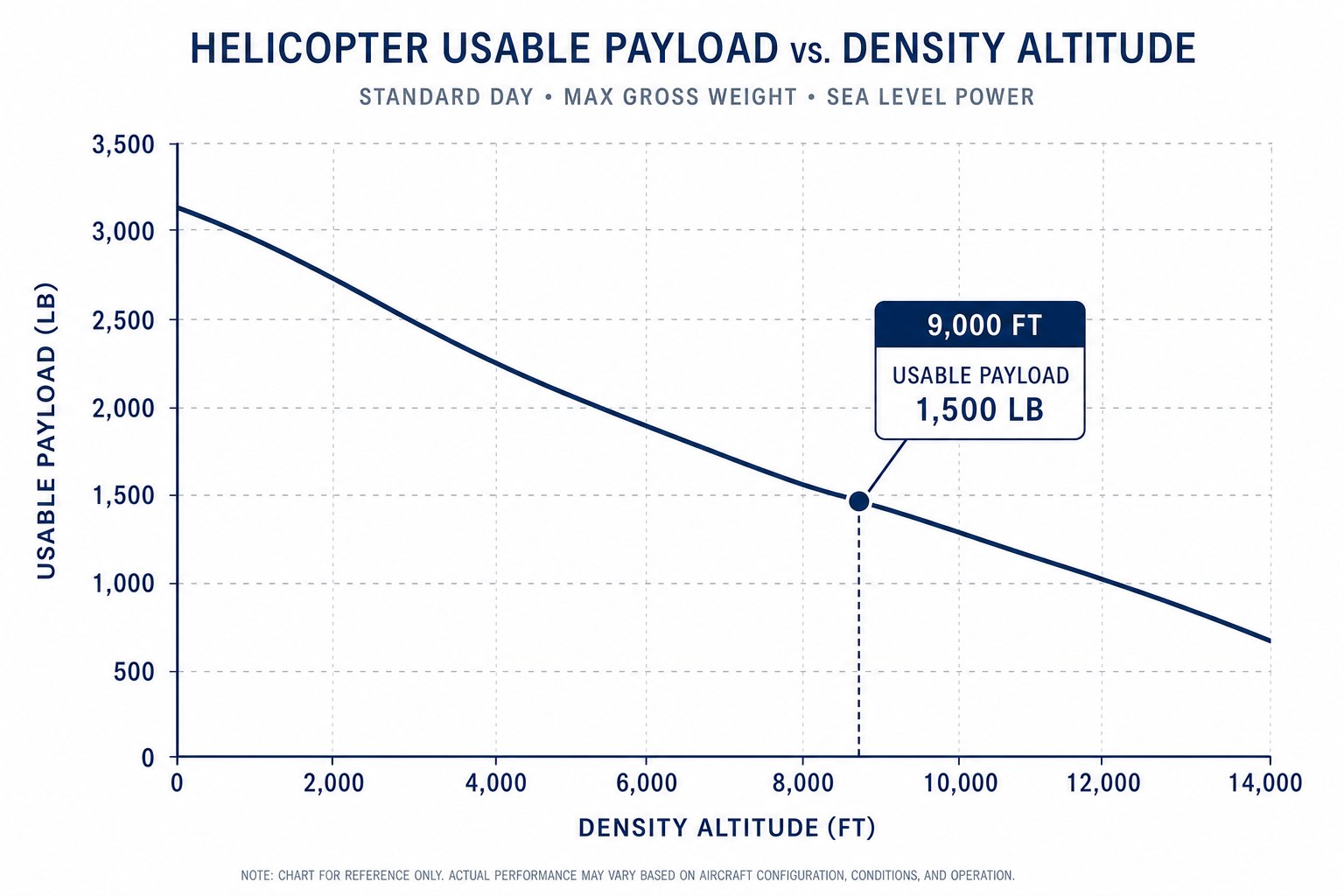

Line chart of usable helicopter payload falling as density altitude rises from sea level to 14,000 feet, with a callout marker at 9,000 feet
Representative utility-class payload curve. Payload falls faster than engine power because empty weight is constant; the lift plan carries the per-day capacity table for the assigned airframe.

The rulebook

The Helicopter Concrete Bucket, the Rigging, and the Regulation

Aerial concrete work is a Class B external load under 14 CFR Part 133: a jettisonable load lifted free of the surface on the cargo hook. The definition is in 14 CFR §1.1.

Jettisonable means the pilot can release the load in flight if the aircraft's performance or the environment requires it. The flight route is planned with that in mind, so an emergency release does not put the bucket over crew or the public. Each component under the hook needs its own standard and inspection:

Element Standard What it means on the pour
Concrete bucketASME B30.20 (below-the-hook lifting devices)Rated, marked and inspected discharge bucket; gate function checked on the schedule the lift plan sets
Slings and hardwareASME B30.26 (rigging hardware); design factor not published hereRigging selected against loaded bucket weight, not empty weight
LonglineNot published hereLine length set for downwash management and placement visibility
Ground crew operationsOSHA 1926.551Daily briefings, control of loose objects and the static-electricity procedure, understood before anyone handles the bucket or line

Design factors are not published here. The rigging design should name the standard covering each component and the inspection criteria that follow from it; ASME B30.26 covers rigging hardware, and sling requirements sit in a different volume of the B30 series.

Clear roles keep the estimate accurate. The operator supplies and maintains the bucket and rigging and works within its Part 133 authority and approved load classes. The pilot in command has final authority over the operation of the aircraft under 14 CFR §91.3, and a pour schedule cannot override it. The contractor covers the pour design, formwork ready to receive at the planned cadence, finishing crew staffing, and a batch source that can hold the schedule. Items at the interface (staging LZ layout, hopper position, signal protocol, discharge procedure) go into the lift plan both crews brief from.

The honest comparison

When a Pump or a Crane Beats Aerial Concrete Placement

A lift plan should compare aerial placement with the ground methods, and an estimator reviewing an aerial proposal should check that it does. Aerial bucketing usually costs more in three common situations:

  • The pump reaches. If a boom or line pump can be staged with existing access and the vertical rise is within its pressure range, the pump is the baseline to beat. Get the pump proposal before considering an aircraft.
  • High-volume pours with road access. A continuous mat or large foundation pour fed by a truck rotation suits ground equipment. Aerial placement fits pours that are remote, high or spread across several sites, rather than large yardage on open ground.
  • Long-duration, low-rate placement. If the pour sequence stretches across weeks at low daily yardage, aviation standby costs can exceed the access savings. A crane and hopper, or staged pumping, may cost less.

The cases for the helicopter are just as specific: no road, no pump reach, environmental or permitting limits on ground disturbance, several scattered pour sites on one corridor, or a fixed energization or in-water work window that weeks of access construction would miss. Compare both methods with the full cost of each, including the helicopter's staging area, ferry charges and standby terms. A proposal that puts the comparison in writing lets the contractor's bid carry the reasoning. Projects that also fly forms, rebar and equipment to the same sites can plan those flights together under remote site freight logistics, so one mobilization serves several line items.

The vetting standard

What a Complete Aerial Pour Bid Package Contains

A vague aerial pour proposal is hard to carry into a bid. The useful ones break into line items the estimate can hold:

  1. Placement rate table. Yards per hour for the aircraft proposed, at the site elevation and forecast temperature band, with the density altitude assumptions stated.
  2. Cycle plan. Staging LZ location, shuttle distance, cycle time, and truck sequencing coordinated with the batch supplier against the ASTM C94 discharge window.
  3. Priced structure. Flight hour rate, ferry, fuel, and standby terms stated separately, so weather-day exposure appears as a number in the risk column.
  4. Compliance file. The named flight operator's Part 133 certificate and approved load classes, insurance documentation checked against the project's actual requirements (including any cargo coverage while the bucket is on the hook and the actual additional-insured provisions), rigging inspection records, and the site-specific lift plan for the safety manager's review.

A package with all four lets the estimator carry the aerial scope as line items, and it should say so when a pump is the better method. When a coordinator arranges the work, the certificate and insurance review still follows the company flying the aircraft. Mobilization time depends on where the aircraft is based and what support it needs, so take it from the proposal rather than assume it.

For related airframe and payload discussion, continue with tower construction and remote site freight, or return to the aerial construction hub for the crane-versus-rotorcraft comparison. New articles on cycle planning and payload are announced through the mailing list.

Frequently asked questions

What Estimators Ask About Aerial Pours

There is no reliable fleet-wide rate. Each bucket carries the aircraft's allowable load for the site and day, less the bucket and rigging, at close to 4,000 pounds per cubic yard of normal-weight concrete. The number of cycles per hour depends on shuttle distance and the work at the hopper and the forms. Use the operator's estimate for the actual pour, with its assumptions stated.

The lift plan checks the aircraft's cycle rate against the mix's initial set time before mobilization. Batch truck arrivals are sequenced to the flight cadence inside the ASTM C94 90-minute discharge window. Where the margin is thin, the plan can add a retarding admixture, a second aircraft or planned construction joints. The schedule prevents cold joints; flying faster on pour day does not.

It falls. Heat, humidity and elevation raise density altitude, and thinner air reduces the aircraft's performance; the FAA Helicopter Flying Handbook, chapter 7, explains the effect. Capacity depends on the specific aircraft and lift-day conditions, so a published figure such as the K-MAX's 6,000 pounds is not the allowable load at a high, hot site. The bucket is downsized or short-filled and cycle counts are recalculated in the lift plan.

The helicopter can come out ahead when the pour sits beyond pump reach and truck access: roadless terrain, a large vertical rise, environmentally restricted corridors, or several scattered foundations along a right-of-way. If a pump can be staged and can push the yardage, the pump is usually the lower-cost method, and the lift plan should say so. Put the comparison in writing during technical vetting, before either method is bid.

The operator supplies the discharge bucket, slings and longline. ASME B30.20 covers below-the-hook lifting devices and B30.26 covers rigging hardware; the rigging design should name the standard and inspection criteria for each component. OSHA 1926.551 requires daily briefings for helicopter construction work and addresses loose objects and static electricity. The pilot in command has final authority over the operation of the aircraft under 14 CFR 91.3.

Yes. A concrete bucket lifted free of the surface on the cargo hook and releasable in flight fits the Class B definition in 14 CFR 1.1. The pilot can release it in an emergency, and routes are planned so a release does not put the load over people. Check that the named flight operator's approved load classes include Class B.
