Helicopter Steel Erection & Infrastructure Placement

Helicopter steel erection puts structural members where crane geometry, ground bearing, or street access fails: heavy lift helicopters set steel at up to 25,000 pounds per pick (Erickson S-64F) and place members within inches. Operators run this work under 14 CFR Part 133, with ASME B30 rigging and a non-impact load-control discipline that holds forces on the fabrication under 0.5 G.

Read the External Load Reference
25,000 lb Maximum steel pick on the Erickson S-64F Air Crane
0.5 G Force ceiling a non-impact protocol holds on the fabrication
10 to 20 Members set per hour on a planned erection sequence

The boundary

When Does Helicopter Steel Erection Beat a Crane?

A crane's capacity chart is a curve that falls with radius. A helicopter's capacity is indifferent to reach. That single difference decides most of the steel work that goes aerial: the member is not too heavy for a crane, it is too far from anywhere a crane can stand.

The picks that end up on a longline share a pattern:

  • Bridge and pedestrian-crossing sections over water, rail corridors, or ravines where there is no crane pad on either abutment.
  • Penthouse steel, dunnage frames, and screen-wall steel on occupied towers where the street below cannot close and a tower crane cannot be justified for a two-day erection scope.
  • Spires, masts, and architectural steel at heights and setbacks that push a mobile crane past its chart or into a lane-closure permit fight.
  • Cell-carrier steel and antenna mounts on existing towers and rooftops, set at 15 to 20 picks per hour instead of a week of hand-rigging. For full structure erection, see Tower Construction.
  • Long-reach picks over occupied structures, where the fall zone a crane boom would sweep is exactly the area the owner cannot vacate.

For the estimator, the math runs through the mobilization line, not the hourly rate. Before a large crawler or tower crane makes its first pick it can absorb $60,000 to $100,000 in transport, assembly, mats, and ground-bearing engineering, plus lane-use fees and police details if the street is involved. Aerial steel placement deletes those line items and compresses the erection window from weeks to hours. When the crane pencils out better, honest vetting says so; the full crane-versus-helicopter comparison lives on the Aerial Construction hub.

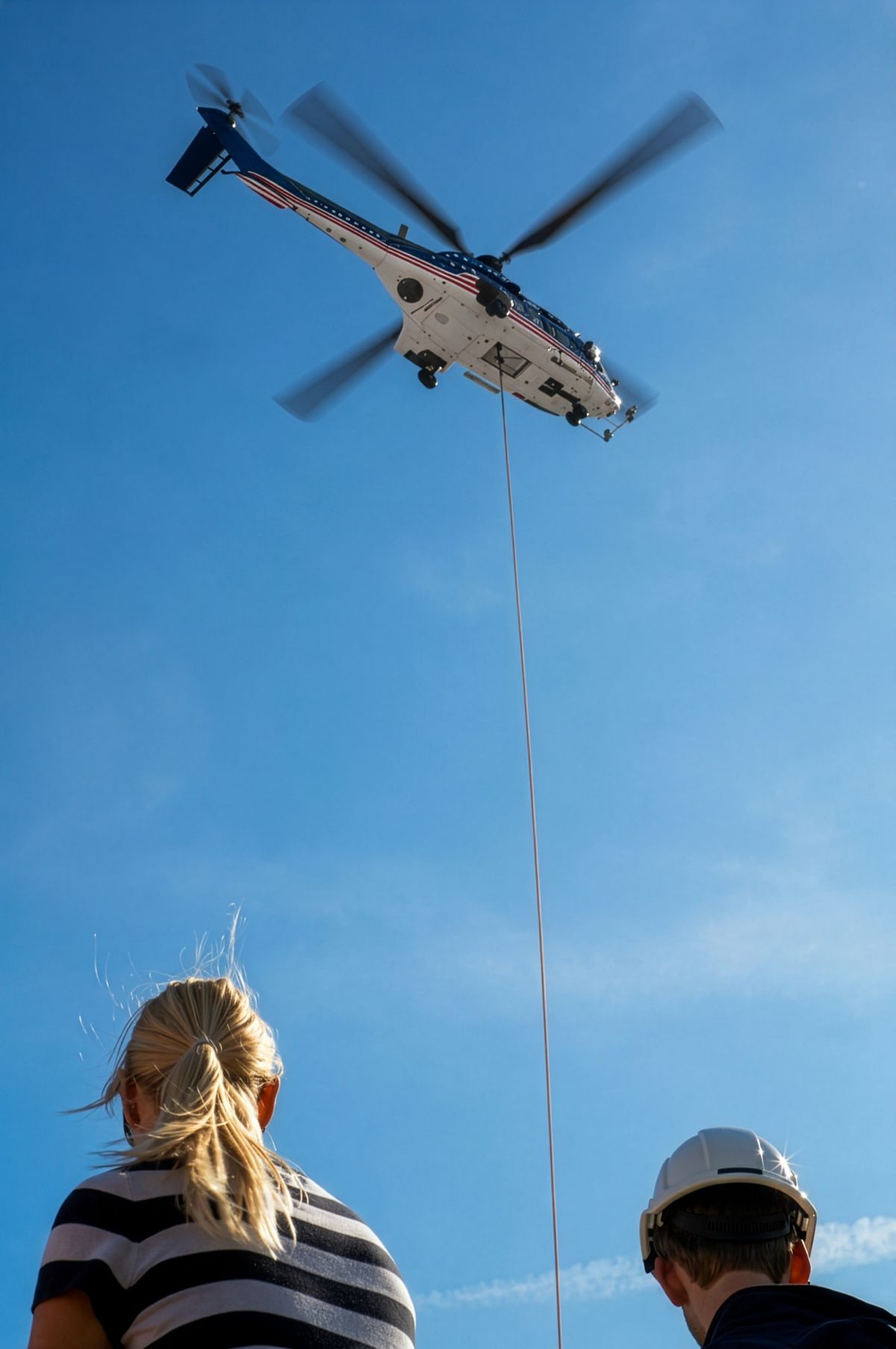

Ground crew looking up at a heavy twin helicopter hovering overhead with a longline during an external load operation
The longline is the crane. Reach that would bury a ground crane's chart costs a helicopter nothing.

The discipline

What Is a Non-Impact Protocol?

A non-impact protocol is the load-control methodology precision operators apply to high-value fabrications: GPS-stabilized hovering and controlled vertical closure that keep G-loading on the suspended asset below 0.5 G from liftoff through release.

A welded truss, a machined bearing assembly, or an architectural spire with a six-month fabrication lead time does not get a second chance. The protocol treats the member as instrumentation, not freight.

In practice that means three controls:

  1. Engineered flight profile. Acceleration, translation, and descent rates are planned against the member's mass and rigging geometry before the aircraft launches, not improvised over the connection point.
  2. Stabilized final approach. The aircraft establishes a stationary hover above the connection, then closes vertically at rates measured in inches per second while ironworkers control alignment from the structure.
  3. No side-loading at release. The load is plumb over its seat before it takes bearing. Hooks release only after the connection crew confirms the member is landed and pinned.

On the S-64F, the aft-facing pilot station gives the pilot in command a direct sightline down the longline to the connection point, which is why that airframe carries so much of the industry's precision steel work.

The airframes

Which Aircraft Do Operators Fly for Structural Steel?

Airframe selection is driven by member weight, placement tolerance, and airspace category, in that order. Working numbers below are maximum external load capacities at standard conditions; density altitude reduces them (plan on roughly 3% power loss per 1,000 feet of density altitude, more in heat and humidity).

Aircraft Max external load Steel erection role Certification category Typical picks/hr
Boeing CH-47D Chinook26,000 to 28,000 lbsHeaviest members: bridge sections, plate girdersRestricted10 to 20
Erickson S-64F Air Crane25,000 lbsPrecision sets; aft-facing pilot stationRestricted15 to 20
Columbia BV-234 Chinook28,000 lbs max; 20,000 lbs precision placementHeavy steel over congested urban areasStandard10 to 15
Bell 214B Big Lifter8,000 lbs longline; 6,614 lbs precisionLighter members, infill steel, carrier mountsStandard15 to 18
Kaman K-MAX K-12006,000 lbsHigh-cycle repetitive picks, lattice steelRestricted20 to 25

Certification category is not a footnote. It decides who can legally fly an urban set, and it is covered in the congested-area section below.

The hardware

How Is the Rigging Engineered and Inspected?

Steel punishes casual rigging. A properly engineered lift plan specifies hardware to ASME B30.20 (below-the-hook lifting devices) and ASME B30.26 (rigging hardware), with design factors that exceed ground-crane practice:

  • Slings: 5:1 minimum design factor against rated breaking strength.
  • Longlines: 7:1 minimum design factor for non-human-external-cargo lines.
  • Spreader and lifting beams engineered to the member's pick points and stamped weights, not to a generic capacity.

Two hardware disciplines matter specifically for steel:

Anti-rotation control. A long plate girder or open truss is an airfoil. Uncontrolled, it will weathervane and spin under the aircraft. Riggers place a swivel at the hook to decouple line torque from the load, and tag lines let the ground crew control heading through the final set. For members with high surface area, the lift plan sets a lower wind ceiling than the aircraft itself requires.

Load geometry. Sling angles, center-of-gravity offsets, and attachment eccentricity are calculated from the fabricator's drawings during technical vetting. A member that hangs 3 degrees off plumb does not seat in its connection at altitude.

Authority is explicit: under Part 133, the pilot in command holds final legal authority over rigging integrity and can refuse any pick. Rigging is inspected before the first cycle and re-inspected on a set interval throughout the operation, per OSHA 1926.551. That regulatory framework, including load classes and the physics behind them, is detailed on the External Load Operations reference page.

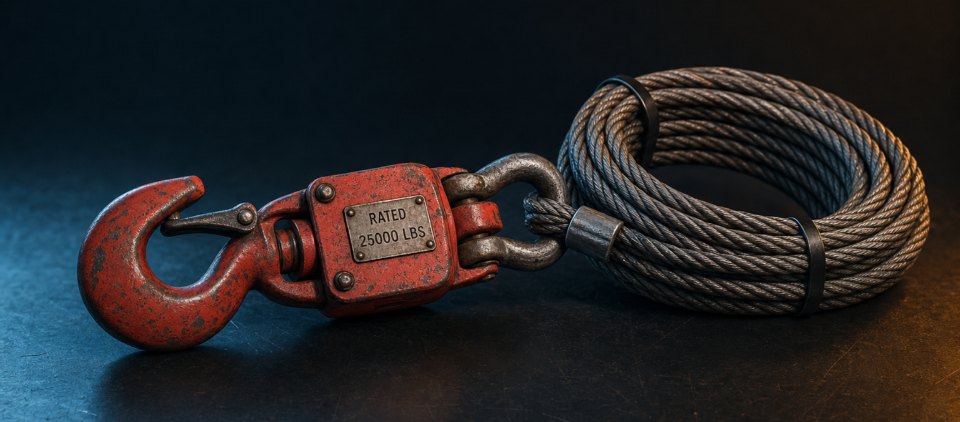

External load cargo hook rated at 25,000 pounds with a coiled steel longline cable, the hardware class governed by ASME B30 standards
Below-the-hook hardware is engineered to ASME B30.20 and B30.26, at design factors that exceed ground-crane practice.

The airspace

Can a Helicopter Set Steel Over an Occupied Building?

Yes, under an FAA-approved Congested Area Plan (CAP) required by 14 CFR 133.31(f) and detailed in AC 133-1A. The operator prepares and files the CAP as part of the mission package. It defines:

  • Flight routes engineered so the load never crosses uncontrolled people or traffic.
  • Fall-zone security agreements with the property owner and adjacent stakeholders.
  • An emergency jettison plan identifying where a load goes if it must come off the hook.

The schedule has to be planned around the review: the FSDO requires a minimum of 5 working days to evaluate a CAP, and experienced planners build that window into the erection sequence alongside NTP and permit milestones.

14 CFR 133.31(f) Congested Area Plan rule 5 working days Minimum FSDO review window

One constraint most erectors have never had reason to learn: aircraft certification category decides which helicopter can fly the urban set. Restricted-category surplus aircraft, including the CH-47D and the S-64 in most configurations, are barred from operations over congested areas. The standard-category BV-234 Chinook, with 20,000 pounds of precision placement capacity, is the legally cleanest heavy airframe for downtown steel. If a proposal quotes a restricted-category aircraft for a pick over an occupied block, the technical vetting failed before the aircraft left the ground.

Urban operations also run under ANSI S12.9 community noise measurement where local ordinances apply, and the compressed timeline is the mitigation: a 90-minute operation generates one morning of noise instead of three weeks of crane assembly, erection, and teardown. The same regulatory stack governs Modular Building Placement and HVAC and rooftop unit work over occupied properties.

The manifest

What Do the Fabricator and Erector Provide?

Role clarity is how a lift day stays boring. The division of responsibility on a well-run helicopter steel operation:

Deliverable Responsible party
Certified load weight per member (scaled or calculated and stamped, including all attached hardware)Fabricator / client
Engineered pick points on the member, with drawingsFabricator / erector's engineer
Rigging design, hardware, and inspection to ASME B30Helicopter operator
Lift plan, load calculations, flight profileHelicopter operator
FAA Part 133 compliance, CAP filing, FSDO coordinationHelicopter operator
Connection crew, tag line handlers, landing zone controlErector, briefed by the operator's ground coordinator
Final go/no-go on every pickOperator's pilot in command

The certified weight requirement is absolute. Takeoff performance, rigging design factors, and the aircraft's placarded external load limit are all computed from that number. An estimated weight is not a lift plan input; a member without certified weight documentation does not fly.

The erector's ironworkers stay on the steel and make the connections. Before the first cycle, the operator's ground coordinator briefs the crew on OSHA 1926.551 requirements: PPE under rotor wash that can exceed 100 mph, static discharge (the longline carries a charge; a grounding conductor touches the load before hands do), tag line handling, and hand signals with radio backup. Connections are designed for rapid landing and pinning: the aircraft holds position for the seat and pin, then releases and returns for the next member while the connection crew completes the bolt-up.

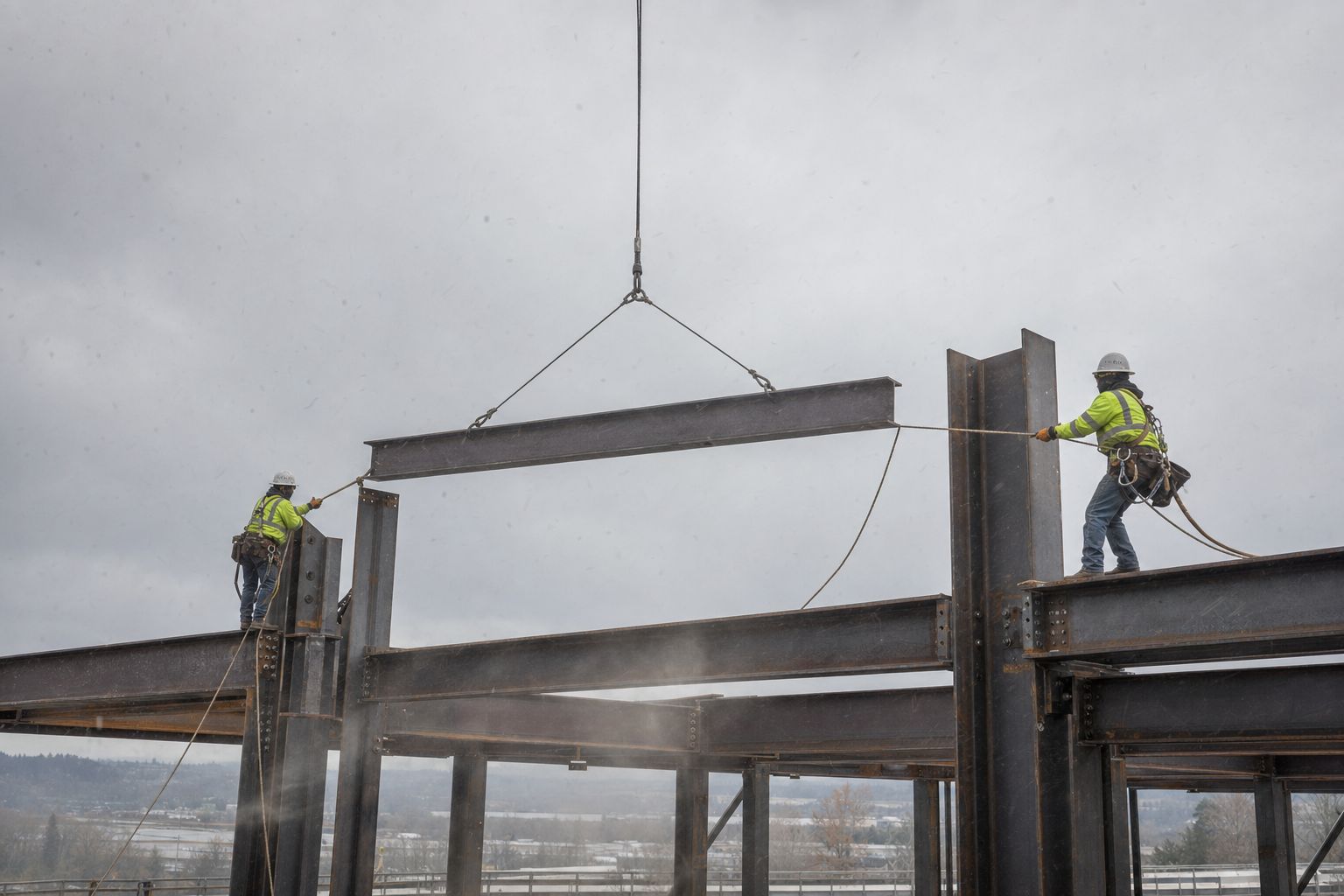

Two ironworkers on open structural steel framing guiding a suspended steel beam into a column connection with tag lines
The connection crew controls alignment with tag lines while the aircraft holds the member plumb over its seat.

The cadence

Why Does Cycle Rate Decide the Bid?

An S-64F or CH-47D executing a planned erection sequence sets 10 to 20 members per hour. Helicopter beam placement at that cadence depends on sequencing engineered in advance from the erection drawings: members staged in flight order at the laydown yard, shake-out matched to pick order, connection crews positioned one set ahead of the aircraft.

For a contractor's bid, that cadence converts directly into protected margin:

  • Labor compression. A raising gang paid for one flight day instead of two weeks of crane cycles.
  • Zero mobilization bleed. No crane assembly, no mats, no ground-bearing analysis, no teardown.
  • Schedule certainty. The erection window shrinks to hours, which shrinks weather exposure and the general conditions burn that comes with it.

Operators typically present the numbers as a fixed-scope logistics package: aircraft, cycle rate, insurance certificates, and permit timeline, structured so an estimator can carry it in a master bid as a single line item.

The honest boundary

When Does the Ground Crane Win?

Solution-agnostic vetting is the standard in this industry, so here is the honest boundary. A ground crane is the better engineering outcome when:

  • The erection sequence requires long static holds. A crane can suspend a member for an hour of fit-up and welding. A helicopter sets and releases; if the connections cannot be designed for rapid pinning, nothing should fly.
  • A single pick exceeds 28,000 pounds. That is the civilian rotorcraft ceiling. Above it, the conversation is about crane class, not airframes.
  • The site has clear access and a long-duration steel scope. A tower crane erecting a high-rise frame over months is the right tool, and no flight-hour math changes that.
  • Placement tolerance demands sustained mechanical guidance. Some slip-critical or machined-seat connections want a load that can be inched under full crane control.
Ground crane rigged on a jobsite, the alternative every helicopter steel lift plan is costed against
Erection drawings on the table, both machines costed honestly, and the engineering comparison decides.

Projects that sit on that boundary get a defensible answer the same way every time: erection drawings on the table, both machines costed honestly, and the engineering comparison decides. Anyone weighing a helicopter lift for structural steel should start with the total-cost framework on the Aerial Construction hub, then go deep on the regulatory mechanics in External Load Operations. Related verticals in this series cover Modular Building Placement and HVAC and rooftop units. New analyses publish to the mailing list first; joining it is the one action this site asks of a reader.

Explore Aerial Construction

Frequently asked questions

What Erectors and Estimators Ask First

Within inches. The Erickson S-64F carries an aft-facing pilot station that gives the pilot in command a direct view down the longline to the connection point, and GPS-stabilized hovering holds the member over its seat while the connection crew controls final alignment with tag lines. Members are placed plumb, landed, and pinned before the hook releases.

Three controls: a swivel at the hook that decouples line torque from the load, tag lines handled by the ground crew to control heading, and a lift plan that sets wind limits for the member's surface area. Long girders and open trusses act like airfoils, so anti-rotation rigging is engineered into every steel lift plan rather than added on site.

The helicopter operator engineers the rigging to ASME B30.20 and B30.26 standards, with minimum design factors of 5:1 for slings and 7:1 for longlines. Rigging is inspected before the first pick and on a set interval during the operation per OSHA 1926.551. Under FAA Part 133, the operator's pilot in command holds final authority over rigging integrity and can refuse any lift.

Yes, under an FAA-approved Congested Area Plan required by 14 CFR 133.31(f). The plan defines flight routes, fall-zone security agreements, and an emergency jettison plan, and the FSDO requires a minimum of 5 working days to review it. Aircraft category matters: restricted-category aircraft such as the CH-47D cannot operate over congested areas, while the standard-category BV-234 Chinook can, with 20,000 pounds of precision placement capacity.

A certified weight for every member, scaled or calculated and stamped, including all attached hardware, plus engineered pick points on drawings. Certified weights drive the rigging design factors, the aircraft performance calculations, and the placarded external load limit check at forecast density altitude. A member without certified weight documentation does not fly.
