Specialized heavy lift: the operations annex

Disaster Relief Helicopter Services

Disaster relief helicopter services carry external loads into areas where roads, bridges and power have been cut. The heaviest published capacity on this page is 28,000 pounds, Vertical's figure for Columbia's Model 234 UT/LR. Operators fly this work under FAA Part 133, inside the federal Emergency Support Function structure, and Corps-administered work adds the USACE EM 385-1-1 safety manual. This page is written for utility, government and infrastructure emergency managers who plan response capability before an event, and for readers who want to see where heavy lift aviation fits in a disaster logistics chain.

The logistics gap

When Infrastructure Is Severed, Disaster Relief Helicopter Services Become the Logistics Chain

A ground logistics plan depends on the road network surviving the event. After a major hurricane, flood, earthquake or wildfire, washed-out bridges, debris fields and flooded corridors can cut off substations, water plants, hospitals and whole communities for days while crews reopen routes.

A helicopter does not need that route. A Part 133 external load operation can deliver to a clearing, parking lot or ridgeline once it has been checked and prepared as a set point, and it can carry loads heavy enough for infrastructure restoration as well as relief supplies. Vertical publishes 28,000 pounds on the hook for Columbia's Model 234 UT/LR, a civil Chinook variant. That is the scale of a transmission structure section, a skid-mounted generator or a temporary bridge component, set close to the crew that needs it.

Where ground access survives or is restored quickly, trucks and ground cranes usually cost less, and the response plan should use them. The helicopter covers the period between the event and the reopened road. In a major disaster, the length of that period drives the restoration schedule.

This page belongs to the Specialized Heavy Lift series and is organized like an operations annex. Anyone drafting an emergency response plan, an emergency operations plan annex or a standby services scope of work will find each section below matched to a question those documents have to answer.

28,000 lbs Columbia Model 234 UT/LR, per Vertical 14 CFR 91.137 Disaster-area TFR rule

The load list

What Loads Matter Most in the First 72 Hours of Grid Restoration?

A grid and infrastructure restoration effort tends to call for the same short list of heavy loads in its first 72 hours. Plan aircraft capacity against that list rather than a generic "relief supplies" category, because the heaviest item on it decides which aircraft the annex has to secure.

Load category Typical mission Aircraft class required
Skid- and trailer-mounted generator setsEmergency power for substations, water plants, hospitals, sheltersHeavy lift (CH-47D, BV-234, S-64 class) for large gensets; medium lift for portable units
Utility poles and transmission structure sectionsRebuilding severed distribution and transmission corridorsMedium to heavy lift; see transmission line stringing
Transformers and substation componentsSubstation restoration where access roads are goneHeavy lift, precision placement
Palletized water, food, and medical suppliesSustainment for isolated communities and crewsMedium lift on repeated short shuttle legs
Fuel in approved external containersGenerator and equipment sustainment at isolated sitesMedium lift, repetitive shuttle profile
Temporary bridge sections and mattingRestoring ground access for the follow-on truck convoysHeavy lift, engineered rigging
Debris removal (external load extraction)Clearing critical routes and structuresMedium to heavy lift with grapple or sling rigging

Two points in this table shape the plan. Generator and transformer missions decide the aircraft class: a load that cannot be split has to fly whole, and among the aircraft with published figures, only the heaviest carry 20,000 pounds or more. Sustainment missions (water, fuel, supplies) depend more on the number of trips than on the size of each load, so a medium aircraft flying repeated short legs can suit them better. The arithmetic is the same as for remote site freight.

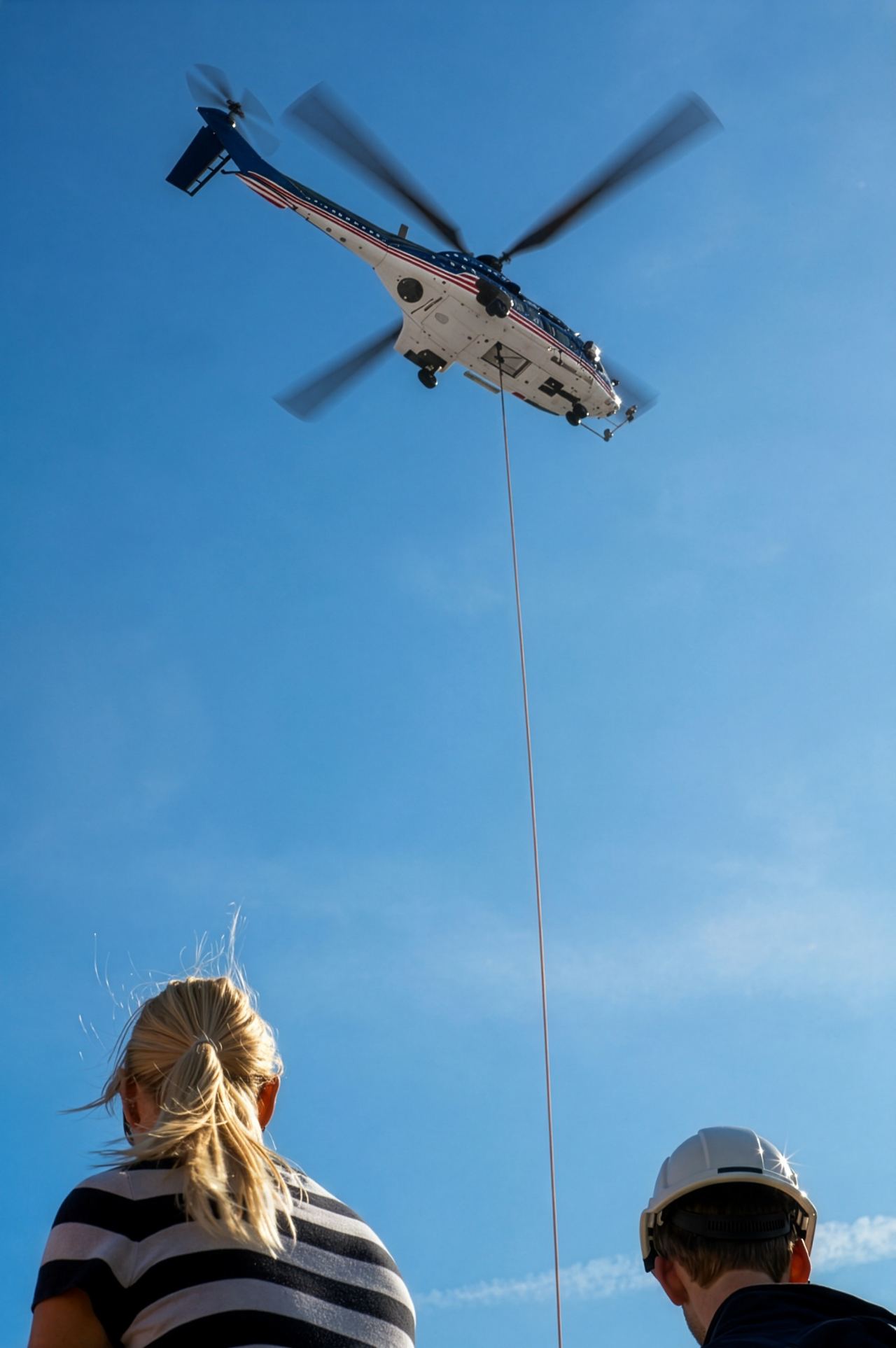

Helicopter delivering a structure section by longline to riggers during infrastructure restoration
Longline delivery puts restoration loads within feet of the receiving crew, no road required.

The airframes

Emergency Helicopter Lift Aircraft and Payload Capacity

Aircraft selection for disaster response weighs hook capacity against availability and the operating environment. The table below lists aircraft relevant to emergency heavy lift, with a source for each published capacity.

Aircraft Max external load Picks per hour Response-relevant notes
BV-234 Chinook (civilian)28,000 lb (Vertical: Columbia's Model 234 UT/LR)Not published hereHeaviest published capacity on this page; generator sets, structure sections, bridge components
CH-47D Chinook (restricted)Not published hereNot published hereHeavy loads; capacity and certification come from the records for the individual aircraft
CH-53DNot published hereNot published hereHeavy Class B slung loads where available; capacity comes from the operator's figures
S-61N (Carson blades)10,000 lb (Helimax: external capacity at standard day, sea level)Not published herePole sets and sustainment shuttles
S-70M Black HawkNot published hereNot published hereUtility restoration and sustainment; hover performance at the site comes from the operator's data

Capacity figures are published maximums from the linked sources, not lift-day allowances. Picks per hour are not published here because the rate comes from the operator's plan for the actual loads, rigging and staging distance. Lift-day payload depends on the specific aircraft and the conditions, including density altitude, fuel state and line length; the FAA Helicopter Flying Handbook, chapter 7 explains the effect, and the external load operations reference covers the planning. Post-storm work in Gulf Coast summer heat is a practical case: hot, humid air raises density altitude and reduces available payload, so the mission plan should use the expected conditions from the first load calculation.

Certification also belongs in the plan. §133.45(d) prohibits external-load operations with rotorcraft type certificated in the restricted category over densely populated areas, in congested airways or near busy airports with passenger transport operations. A disaster zone can include all three. Check the individual aircraft's certification against the delivery points and the route from staging, rather than assuming it from the model name.

The launch package

How Fast Can Helicopters Mobilize for Storm Response?

Most of what decides response speed is arranged before the event. A heavy lift launch package includes the flight crew, the ground crew and rigging inventory, a fuel plan and the maintenance support that keeps the aircraft working from a forward operating point. When that package is planned in advance, less of it has to be assembled after the call. How long mobilization takes still depends on where the aircraft is based and what the agreement provides.

The mobilization sequence runs in four phases:

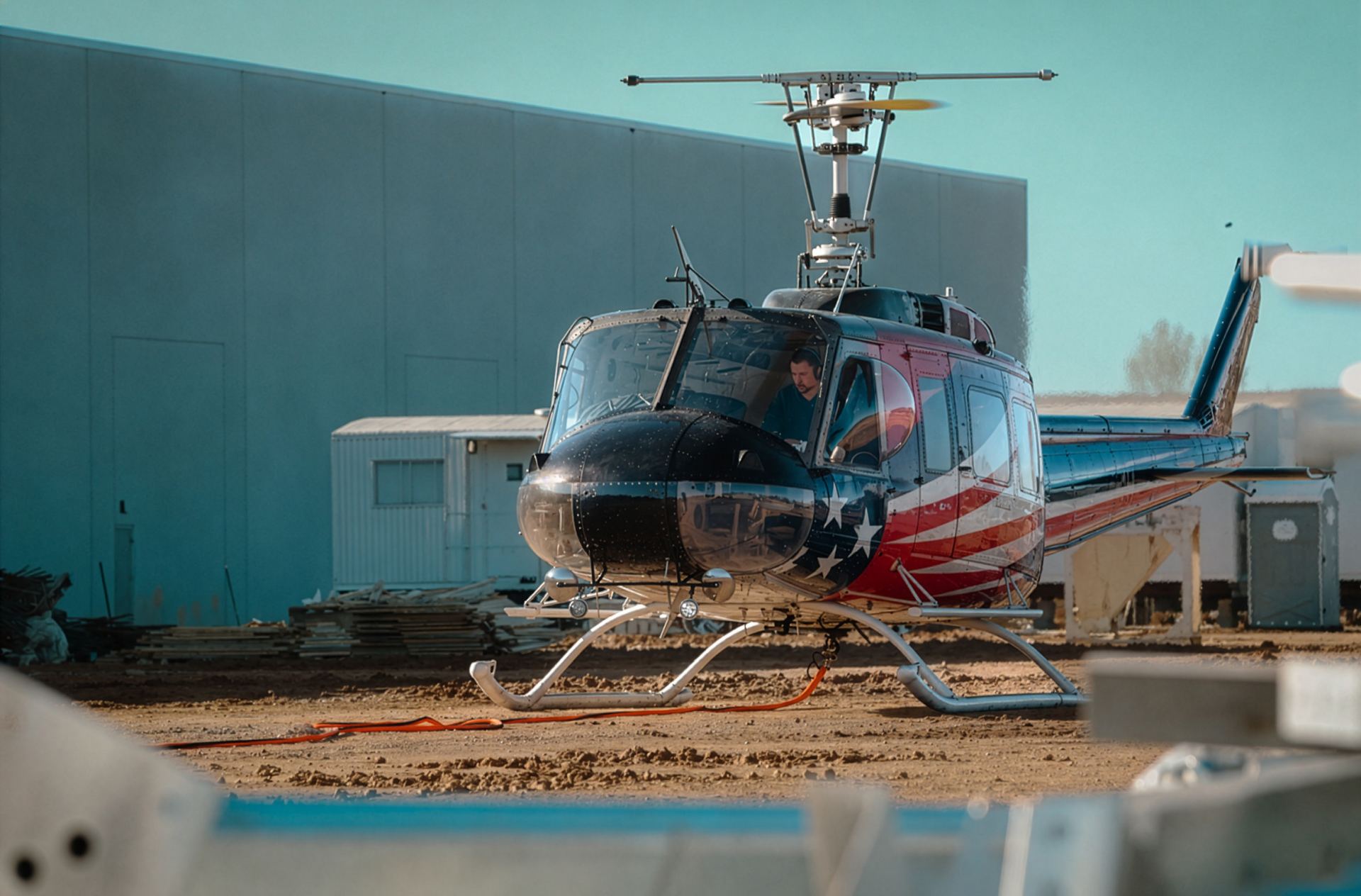

Utility helicopter parked on a dirt staging yard with ground support equipment during forward operations
Forward staging: operators run lift cycles from a staging area outside the damage zone, with ground crew and fuel support in place.

Phase 1: Alert and Validation

The activation call starts a review of the loads. The operator needs to know what must fly, what each load weighs from documented weights rather than estimates, and what the receiving site looks like. Planning staff check aircraft selection and rigging requirements against the load list while the crew and launch package are recalled.

Phase 2: Launch and Ferry

The aircraft ferries to the staging area, and ground support travels by road in parallel where routes permit. Ferry time follows from distance and cruise speed, so it is the most predictable part of the response timeline. Pre-positioning and standby agreements, covered below, exist to shorten it.

Phase 3: Forward Operations

Lift operations run from a staging area outside the damage zone. Loads are rigged, cycle times are established and the aircraft flies a continuous rotation. Delivered tonnage depends on the payload per trip, the length of the shuttle and the work at both ends, so staging location deserves as much planning attention as the aircraft.

Phase 4: Sustainment or Standby Reset

Operations continue until ground access is restored. The aircraft is then released or returned to standby for the next tasking.

Response-time commitments vary by operator and contract structure. Treat any published mobilization figure as conditional on where the aircraft is based, what it is doing when the call comes and what the agreement committed in advance.

The airspace

Can Helicopters Fly Relief Missions Inside Restricted Airspace?

Yes, with coordination. After a major disaster the FAA may issue a Temporary Flight Restriction over the affected area under 14 CFR 91.137 to keep uncoordinated aircraft out of the response airspace. Aircraft participating in disaster relief operations may operate inside that TFR when flying under the direction of the official in charge of on-scene emergency response activities.

In practice, the lift contractor joins the incident's air operations structure. That means obtaining access authorization, following any airspace coordination procedures and flying assigned routes and altitudes alongside search and rescue flights, utility patrols and media restrictions. Ask how the named flight operator has worked within that structure on earlier incidents, because the answer shows how quickly it can be integrated.

Part 133 planning carries more weight in a damaged environment. Landing zones have not been surveyed. Debris can be lifted by rotor wash at every pickup and set point. Towers and wires may be down, unlit or unreported. Ground crews may include utility and agency personnel who have never worked under a helicopter. Ground crew briefings, a site plan for each set point and the pilot in command's authority over the operation of the aircraft under 14 CFR §91.3 keep an emergency operation from creating a second emergency.

Federal coordination

How Do Operators Coordinate With FEMA and the Corps of Engineers?

Federal disaster response is organized under the National Response Framework through Emergency Support Functions, and heavy lift aviation touches several of them. ESF #1 (Transportation) and ESF #3 (Public Works and Engineering) are the main channels for infrastructure lift work, and ESF #12 (Energy) sets grid restoration priorities. The U.S. Army Corps of Engineers leads ESF #3, including temporary emergency power missions, which is where many air-placed generator requests begin.

Contractors doing lift work on Corps missions operate under USACE EM 385-1-1, the Corps safety and health requirements manual. For an aviation contractor, that means activity hazard analyses for lift operations, crew qualification records and equipment inspection documentation. An operator that keeps those records current through the year can take a federal mission assignment without assembling them under deadline. Check the contract to confirm whether the work is Corps-administered and which requirements it carries.

State and utility channels matter as well. Investor-owned utilities activate mutual assistance networks after major storms, and their contractor safety prequalification systems (ISNetworld, Avetta) still apply during a hurricane. Complete the review during blue-sky contracting: the prequalification standing, the Part 133 certificate and insurance of the named flight operator, checked against the project's actual requirements. When a coordinator arranges the aircraft, the certificate check follows the operator that will fly it. The 48 hours after landfall leave little time to onboard a new vendor.

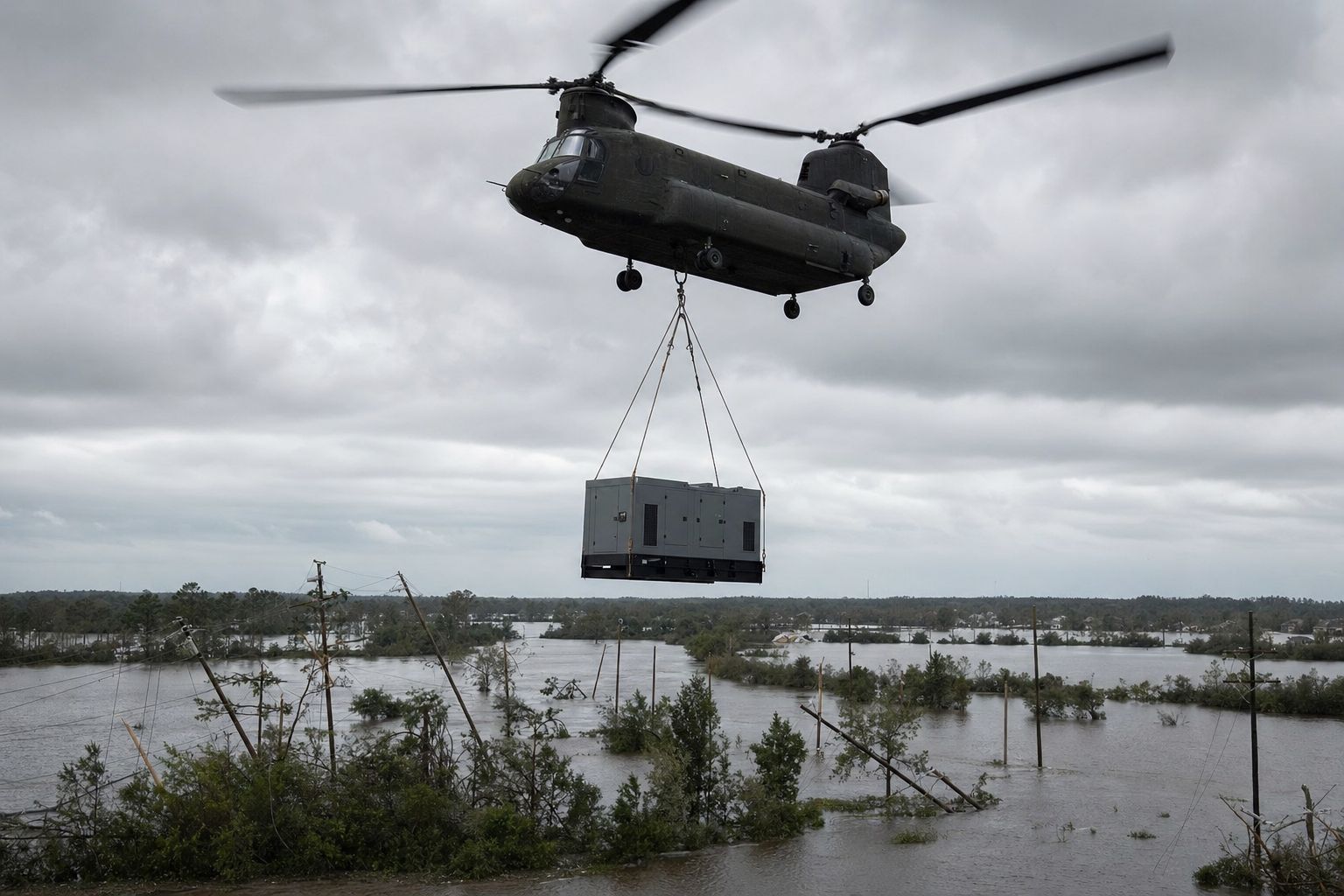

Tandem-rotor heavy lift helicopter carrying a skid-mounted generator set on a sling line over flooded terrain with downed power lines below
Temporary emergency power missions under ESF #3 frequently begin with a generator set on a sling line.

Readiness structures

Standby and Readiness Contracting Structures

The contracting work for a hurricane response is done months before the season. Three structures are common in emergency heavy lift, and each sets a different expectation for response speed:

Call-when-needed (CWN) agreements. Rates, terms, insurance and safety documentation are negotiated in advance, and the aircraft is committed only on activation. CWN carries no standby charge until it is used, but availability is not guaranteed when a regional event activates many operators at once.

Seasonal standby. A daily standby rate holds a specific aircraft and crew in readiness for a defined window, such as hurricane season for coastal utilities or fire season in the West. Standby secures a named aircraft, and the agreement sets how quickly it has to be ready after activation.

Retainer plus activation. A smaller annual retainer secures priority activation status and completed onboarding, with full rates applying only during activation. This suits agencies and cooperatives that need assured access without funding a dedicated standby aircraft.

Whichever structure fits a program, the agreement should show the same billing lines: standby day rate, ferry time, flight hours, fuel and crew per diem. The helicopter lift cost versus crane analysis breaks down that cost structure line by line. For a utility, compare the standby cost against the consequences of a longer restoration, and confirm with the reimbursement program how pre-contracted aviation costs are treated before relying on recovery.

The honest comparison

When Ground Assets Win

Compare every method in an emergency, as on a construction project. If the road network to the work site survives, trucks usually move sustainment loads at a lower cost per ton. If a single heavy component has to be placed at a site with intact crane access and no urgent deadline, a ground crane usually wins. Helicopters justify their rate in three conditions: access is cut, each day of outage carries a real cost, or building or rebuilding access would cost more than the flight program. Confirm which condition applies before requesting an aircraft, and plan the ground method when none of them does.

The reading path

Continue the Analysis

Emergency lift capability is set up during planning, and the rest of this series covers what that planning depends on. The external load operations reference explains the Part 133 framework behind every mission above: the certificate, load classes, congested area plans and rigging design. Remote site freight covers the shuttle arithmetic behind sustainment airlift, and drop testing shows external load work at its most precise. The full set of topics is on the Specialized Heavy Lift hub. New analyses in this series are announced through the mailing list.

Frequently asked questions

What Emergency Managers Ask First

It depends on the contract structure and the ferry distance. A seasonal standby agreement holds a specific aircraft and crew, and the agreement sets how quickly they must be ready after activation. A call-when-needed activation adds crew recall, launch package assembly and availability, plus ferry time to the staging area. The work done before the event has the largest effect on response speed.

Generator sets for substations, water plants and hospitals come first, followed by utility poles, transmission structure sections, transformers and fuel for generators already in place. The heaviest published figure cited on this page is 28,000 pounds, Vertical's figure for Columbia's Model 234 UT/LR, which covers large skid-mounted generators and structure sections that cannot be split or trucked around cut routes. Capacity for a specific aircraft comes from that aircraft's figures and the lift-day conditions.

Federal response work runs through Emergency Support Functions under the National Response Framework, mainly ESF #3 (Public Works and Engineering, led by the U.S. Army Corps of Engineers) and ESF #12 (Energy). Contractors on Corps missions work under the USACE EM 385-1-1 safety requirements, which include activity hazard analyses and crew qualification records. Those records are easiest to produce when they are kept current before the event.

Yes. Disaster-area Temporary Flight Restrictions issued under 14 CFR 91.137 permit aircraft participating in disaster relief operations when they fly under the direction of the official in charge of on-scene emergency response. The operator coordinates access, routing and altitudes through the incident's air operations structure before launching.

Three structures are common: call-when-needed agreements with pre-negotiated rates but no committed aircraft; seasonal standby, which holds a specific aircraft and crew at a daily rate for a defined window such as hurricane season; and retainer-plus-activation hybrids that secure priority status for a smaller annual fee. Of the three, seasonal standby is the one that commits a named aircraft, and its agreement sets the readiness time.

It depends on the aircraft. Vertical publishes 28,000 pounds on the hook for Columbia's Model 234 UT/LR, the heaviest figure cited on this page, and Helimax lists 10,000 pounds of external capacity at standard day, sea level for its S-61N. Lift-day payload is lower when heat, elevation or fuel state reduce performance, so the operator has to show capacity for the specific aircraft and conditions.
