Reading path 02: Utility and infrastructure

Utility Helicopter Services for Grid & Infrastructure

Utility helicopter services move external loads into corridors, ridgelines, and rights-of-way where a crane cannot be set up at a workable cost. Published hook capacities in the aircraft table below run to 28,000 pounds, and every mission flies under FAA Part 133. Work near energized conductors is planned around a documented minimum approach distance and the utility's own clearance requirements. This guide covers the mission sets, the aircraft, and the qualification documents, written for EPC procurement leads, electrical contractors, and utility program managers reading before the work reaches a bid.

Read the Part 133 Reference
28,000 lb Highest published hook capacity in the aircraft table below
Part 133 The FAA rule governing civil rotorcraft external load operations
Class C The Part 133 load class that defines wire and sock-line stringing

The country is rebuilding its grid on terrain that was hard to reach the first time. Aging transmission corridors, renewable interconnections, and pipeline integrity programs converge on the same constraint: many structure sites sit in mountains, wetlands, and environmentally restricted corridors where crane access means building road first. Aerial external-load operations change what that access costs. A tower section, a drill, a compressor valve assembly, or a sock line moves by air from a staging area, and the road to each structure site is never built. What the flying costs and what the avoided road package costs both belong in the same comparison.

Four mission sets carry most of the work in this category: Tower Construction, Pipeline Construction & Surveys, Transmission Line Stringing, and Mining Operation Support. All of them fly under 14 CFR Part 133, the FAA's Rotorcraft External-Load Operations rule, explained on the External Load Operations reference page.

The procurement math

Why grid and pipeline programs mobilize utility helicopter services

Three line items drive the procurement math, and ground equipment cannot escape any of them in utility terrain.

Access road elimination. A mile of temporary access road through steep or wetland terrain carries cut-and-fill, matting, culvert, and restoration costs, plus the permitting time that ground disturbance in a regulated corridor adds to the schedule. A helicopter flying from a staging area on existing road takes the road to each structure site out of that package. It does not take out ground work altogether: the staging area, the pickup zone, and the flight route need protection of their own. On a multi-structure rebuild the avoided road mileage, not the flight hour rate, usually decides the comparison, so price the mileage before pricing the aircraft.

The outage window. On an energized-corridor rebuild the schedule is the product. Flying tower sections can compress work that would otherwise take weeks of road building and crane walks, though the duration comes from the operator's estimate against the actual structure list rather than from a standard rate. Shorter outages protect the utility's reliability metrics and the contractor's liquidated-damages exposure, and both belong in what the schedule is worth.

Environmental permitting. Aerial delivery avoids the road cut, the matting, and the rutting at the structure sites it serves, which is the disturbance that matters in wetlands, riparian buffers, and habitat-restricted sections. It does not settle the corridor's permitting questions. Where a ground spread would trigger Section 404 review or run into a seasonal closure, take the aerial plan to the permitting authority and the existing right-of-way authorization before assuming it proceeds. The Pipeline Construction & Surveys page covers the ground-disturbance comparison.

The comparison runs the other way as well, and a useful technical vetting runs it that way. When the site already has road access, when the picks are steady and long in duration, or when a single component is heavier than the available aircraft can carry, the ground crane is the better choice.

The clearance discipline

How do powerline helicopter services work safely near energized lines?

OSHA 1926.1408 sets minimum clearance distances from energized power lines by voltage class for cranes and derricks in construction work. Helicopter crane operations have their own standard in OSHA 1926.551. A lift plan near an energized circuit should state the minimum approach distance it works to, the measures that prevent encroachment on it, and the utility's own clearance requirements where those are stricter. Have the plan name the source of each distance, because a clearance carried across from ground equipment is not the same authority as one the utility sets for its own circuit.

Two conditions shape the plan beyond the clearance table.

Twin-engine redundancy. Near an energized conductor, an engine failure cannot be allowed to put the aircraft into the wire zone. Line-proximity work is commonly flown with twin-engine aircraft such as the Bell 412EP for that reason. Engine count alone does not settle it. What the aircraft can do on one engine at the day's weight and conditions comes from its flight manual performance data, so ask for that basis rather than the configuration. The Transmission Line Stringing page covers the practice in full.

Static discharge. A helicopter in flight builds a static charge, and the suspended load carries it. OSHA 1926.551 requires that charge to be dissipated with a grounding device before ground personnel touch the load. The procedure belongs in the daily briefing the same standard requires, and the linemen and ground crew need to have heard it before the first load arrives.

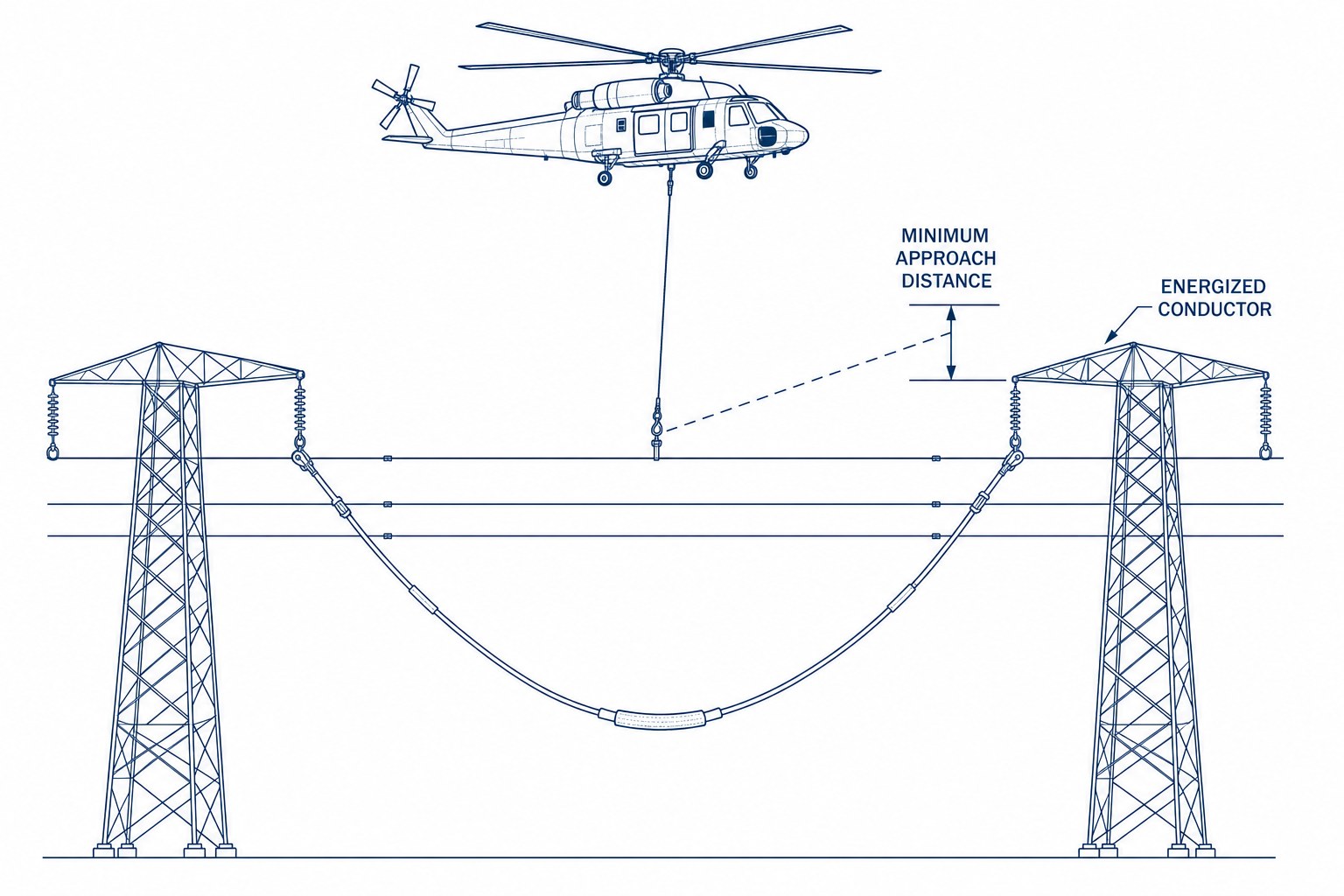

Diagram of a helicopter pulling sock line between two lattice transmission towers with the minimum approach distance labeled from the energized conductor per OSHA 1926.1408
OSHA 1926.1408 Crane and derrick clearance by voltage class OSHA 1926.551 Helicopter crane ground crew standard

The load classes

Part 133 load classes on utility work

Part 133 defines four external-load classes, and utility work is where the distinctions earn their keep. Class B covers a load carried free of the land or water and releasable in flight, which is the profile for tower sections, drills, valves, and mats on the hook. Class C covers a releasable load that stays in contact with the surface during the operation, and that is what wire and sock-line stringing is. The operator's certificate and its Rotorcraft-Load Combination Flight Manual have to authorize each class flown. When a utility's vendor-qualification questionnaire asks which classes an operator holds, that is the question it is asking, and the answer should name the company that will fly the work.

The airframes

Aircraft for utility infrastructure aerial support

A published capacity is a maximum measured under stated conditions, not an allowance for a particular lift. The real figure depends on the specific aircraft and on lift-day conditions, among them density altitude, the air density at the site expressed as an altitude. No single percentage describes that effect across airframes; the FAA Helicopter Flying Handbook, chapter 7 explains how conditions change performance.

Aircraft Max longline / hook Picks/hr Utility application
Columbia BV-234 Chinook28,000 lb (Vertical: Model 234 UT/LR, on the hook)Not published hereHeaviest grid components in this table
Boeing CH-47D ChinookNot published hereNot published hereTandem rotor heavy lift for tower sections
Sikorsky S-70M Black HawkNot published hereNot published hereMedium lift for corridor and high-elevation sets
Bell 214B Big LifterAbout 8,000 lb (McDermott Aviation: 3,636 kg maximum hook load)Not published hereSingle-engine medium for lighter corridor loads
Kaman K-MAX K-12006,000 lb (Kaman: published lifting capacity)Not published hereIntermeshing rotors, built around repetitive external load work
Bell 412EP4,500 lb (Avincis specifications, page 4: maximum hook load)Not published hereTwin-engine redundancy near energized circuits
Bell 212 Eagle SingleNot published hereNot published hereLight utility lifter for lower-weight corridor loads

The sources above state different measurement bases, so the figures are not interchangeable lift-day allowances. Cycle rate belongs to the operator's estimate against the actual structure list and is not published here. Certification category belongs to the specific aircraft's certification record and is not published here either. Section 133.45(d) prohibits rotorcraft type certificated in the restricted category under §21.25 from external load operations over densely populated areas, in congested airways, or near a busy airport with passenger transport operations. That prohibition is defined by where the operation takes place, so remote corridor work does not automatically fall inside it, but the specific aircraft's certification and operating limitations still decide the question, and variants of one model do not all carry the same category.

The reading paths

Helicopter infrastructure construction: the four mission sets

Twin-engine helicopter overhead with a longline during a utility tower lift

Mission set 01

Tower construction

Transmission towers, telecom masts, and met towers flown and stacked where crane mobilization is impractical. Sections arrive tag-line controlled, aligned, and pinned, and the aircraft chosen for a high set follows the density altitude at the structure rather than the catalog figure. Tower Construction.

Field study 01
Sikorsky S-61 lowering a concrete hopper on a longline to a remote alpine job site as ground crew signals

Mission set 04

Mining operation support

Drill moves, camp modules, fuel, and mill components flown to roadless, high-elevation sites. The full high, hot, and heavy density-altitude treatment is on that page. Mining Operation Support.

Field study 04

Sikorsky medium twin parked on an offshore platform helideck with the drilling derrick behind it

Mission set 05

Offshore and oil rig support

Crew rotation, deck cargo, and the narrower band of external load work over water. How the flying divides between Part 135 and Part 133, and why helideck limits often decide the aircraft before payload does. Offshore and Oil Rig Support.

Field study 05

The paperwork

Vendor qualification: what utilities require from aviation contractors

Utility and EPC procurement runs on documentation, and an aviation contractor should be qualifiable as fast as any other subcontractor. This is the package a compliance-driven buyer can audit before an aircraft appears on a lift plan:

Qualification item What the buyer should require
FAA Part 133 certificateCurrent Rotorcraft External-Load Operator Certificate held by the company that will fly the work, covering the load classes the scope requires
Safety Management SystemDocumented SMS covering hazard identification, risk assessment, and management of change
Contractor prequalificationISNetworld or Avetta registration, current and in good standing
Safety metricsRecordable incident rate and experience modification rate, documented and current, read against the thresholds the project's own contract sets
Insurance stackAviation hull and liability, the scope of any cargo coverage while the load is on the hook, and the actual additional-insured and waiver-of-subrogation provisions, checked against the project's requirements rather than assumed
Federal work standardOperations conforming to USACE EM 385-1-1 on Corps and federally contracted infrastructure

Role delineation is part of the same discipline. The pilot in command holds final authority over the operation of the aircraft under 14 CFR §91.3 and can refuse a pick. The contracting client supplies certified load weights and engineered pick points. The operator checks those load parameters against the aircraft's limitations for the forecast conditions before it launches. Where a coordinator arranges the lift, identify the company that will fly it and keep the certificate and insurance review attached to that operator. Precision about who owns what is what lets an estimator price aerial work without padding the number.

The wider library

Readers researching work outside the utility corridor can continue with this site's other two verticals: aerial construction helicopter services for commercial building work, and specialized heavy lift missions for disaster relief, drop testing, and remote site freight. New analyses in this series are announced through the mailing list. The About page covers the rotor wing enthusiasts who publish the site.

Frequently asked questions

What Utility and EPC Buyers Ask About Aerial Work

The lift plan states the minimum approach distance it works to and where that distance comes from: OSHA 1926.1408 sets clearance distances by voltage class for cranes and derricks, helicopter crane operations have their own standard in OSHA 1926.551, and the utility's own limits apply where they are stricter. Line-proximity work is commonly flown with twin-engine aircraft such as the Bell 412EP, though what the aircraft can do on one engine at the day's weight comes from its flight manual rather than from engine count. OSHA 1926.551 requires the static charge on a suspended load to be dissipated with a grounding device before ground personnel touch it.

A Class C external load is releasable but remains in contact with land or water during the operation. Wire and sock-line stringing is the standard example: the line pays out along the ground as the helicopter pulls it between structures. The operator's certificate and its Rotorcraft-Load Combination Flight Manual must authorize Class C operations specifically, so match that authorization to the scope before the work is awarded.

The saving is the road package avoided at the structure sites actually flown: the cut-and-fill, matting, culvert, restoration, and permitting time that a mile of temporary road through steep or wetland terrain carries. It is not the whole ground cost. The staging area, the pickup zone, and the flight route still need protection, and ferry time and support arrangements sit in the aerial estimate. No published figure covers every corridor, so compare complete proposals for the same structure list.

A current FAA Part 133 certificate covering the required load classes, held by the company that will fly the work; a documented Safety Management System; ISNetworld or Avetta prequalification in good standing; and recordable incident and experience modification rates, current and read against the thresholds the contract sets. Check the insurance actually carried, including cargo coverage while the load is on the hook and the additional-insured and waiver-of-subrogation provisions, against the project's requirements. On federal work, conformance to USACE EM 385-1-1 should be explicit in the contract.

Aerial delivery avoids the road cut, the rutting, and the matting at the structure sites it serves, which is the disturbance that drives review in wetlands, riparian buffers, and habitat-restricted sections. It does not remove the corridor's permitting questions. Staging areas and any remaining ground work still need authorization, and corridor-specific permits and seasonal restrictions still govern, so take the aerial plan to the permitting authority before assuming it proceeds inside the existing right-of-way authorization.
